Villa Renovation Cost Dubai 2026
Villa renovation cost in Dubai depends on the area being changed, the property condition, the number of kitchens and bathrooms, structural and MEP work, finishes, external scope, access and approvals. This guide compares published AED planning ranges and shows what a property-specific quotation needs to include.
Published · Updated

How Much Does It Cost to Renovate a Villa in Dubai?
Published rates in Dubai in 2026 show why one headline price is unreliable. FavoriteHome lists AED 150–300 per sq ft for a cosmetic refresh, AED 350–600 for a mid-range project and AED 600–800+ for premium or luxury work. Property Finder publishes total examples from AED 250,000–400,000 for its 3BR townhouse scenario to AED 1.5–3.5 million+ for its luxury scenario.
These are third-party planning estimates, not a verified market average or an 800 Master Renovations price list. The sources use different area bases, inclusions and scope labels, so their figures should not be blended into one average cost. The actual cost for a villa renovation in Dubai can be established only after the active area, retained work, condition, specification, approvals and supply responsibilities are documented.
- Use the ranges as an early plausibility check, not a quotation.
- Confirm which square footage and which rooms the calculation covers.
- Separate construction, supplied products, approvals, deposits and VAT.
Villa Renovation Cost in Dubai 2026: AED per Square Foot
FavoriteHome publishes the tiers below. The descriptions and amounts remain that provider’s planning figures. Square-metre equivalents are rounded using 1 sq m = 10.764 sq ft; they do not turn the source into a universal Dubai rate.
| Decision | Scope described by source | Published planning range |
|---|---|---|
| Cosmetic refresh | Painting, flooring over viable surfaces and fixture swaps without layout or MEP changes | AED 150–300/sq ft; about AED 1,615–3,229/sq m |
| Mid-range | New kitchen, full bathrooms, flooring, some custom joinery and moderate layout or MEP work | AED 350–600/sq ft; about AED 3,767–6,458/sq m |
| Premium / luxury | Imported finishes, bespoke joinery, automation and potentially structural or full MEP work | AED 600–800+/sq ft; about AED 6,458–8,611+/sq m |
Villa Renovation Cost by Size and Project Scope
Property Finder published these scenarios on 24 September 2025. They combine villa type with a stated scope, which is more useful than bedroom count alone. A 4-bedroom villa in Dubai Hills Estate can have a different area and service baseline from a villa in Arabian Ranches; names of villa communities do not replace measurements. These are third-party examples, not prices offered by 800 Master Renovations.
| Decision | Example scope in source | Published estimated range |
|---|---|---|
| 3BR townhouse | Interior plus kitchen and bathroom work | AED 250,000–400,000 |
| 4BR independent villa | Interior plus landscape scope | AED 600,000–850,000 |
| 5BR legacy villa | Complete upgrade plus smart systems | AED 900,000–1,400,000 |
| Luxury villa | Structural work plus premium materials | AED 1,500,000–3,500,000+ |
What a Villa Renovation Cost Calculator Can and Cannot Show
A calculator can multiply an agreed active area by a published rate. For example, applying AED 350/sq ft to a 3,000 sq ft villa produces an illustrative AED 1,050,000 planning figure. It is not a quote. When renovating a villa, define whether the size of your villa means total built-up area, only changed internal rooms, or a wider figure containing garages, terraces and service blocks. Plot size is not the same as renovated floor area.
A simple formula cannot see leaking roofs, undocumented alterations, old wiring, drainage falls or the number of wet areas. It also cannot decide whether demolition, kitchen appliances, loose furniture, pool work, landscape, consultant services, approvals and VAT are included. Use a calculator to test a villa renovation budget in Dubai, then replace assumptions with measured quantities, product allowances and a room-by-room scope.
Cosmetic Upgrade, Partial Renovation and Full Villa Scope
The scope label changes what the total means. Apartment renovation and home renovation in Dubai use the same measurement discipline, but a villa can add roof, façade, garden and pool interfaces. These are planning definitions, not fixed company packages.
| Decision | What can remain | What needs definition |
|---|---|---|
| Cosmetic upgrade | Layout, viable services and most fixed elements | Preparation, paint, selected flooring and limited fixture replacement |
| Partial renovation | Named rooms, floors or systems outside the work zone | Changed zones plus every transition and connection to retained work |
| Full villa renovation | Only surveyed elements deliberately marked for retention | Property-wide strip-out, MEP, wet areas, finishes, testing and handover |
| Luxury renovation | The same measured scope discipline still applies | Premium stone, specialist glazing, bespoke joinery or automation must be specified |
Structural Changes, Extensions and Layout Costs
Removing a wall, widening an opening, changing a staircase or adding floor area cannot be priced as decoration. The existing structure, proposed loads, consultant input, temporary works, demolition method, making good and approval route all belong in the brief. Do not assume every alteration needs the same permit from Dubai Municipality; identify the property jurisdiction and the actual work first. Available drawings are useful evidence, but they are not proof of what will be found after safe opening-up.
An extension adds junctions with the existing roof, façade, glazing, waterproofing, drainage and services. Keep extension work distinct from interior work in the cost plan so design, authority review and external interfaces remain visible. A retained-layout house renovation is normally easier to define than a scheme that moves openings, stairs and wet zones, but the actual difference still depends on the property.
Kitchen, Bathroom and Wet-Area Cost Drivers
Kitchen renovation costs follow cabinet and worktop quantities, internal hardware, appliances, extraction, lighting, electrical load, plumbing points and layout changes. A material allowance cannot cover missing cabinetry measurements or an undefined appliance package. Record which existing services are tested and retained before pricing only visible finishes.
For bathroom renovation, list every fixture position, drainage route, water supply, ventilation point, substrate, waterproofing detail, water test, tile area, sanitaryware item, mixer, vanity, mirror and glass screen. Several bathrooms can share mobilisation, but each still needs a schedule. The room-cost guides cover those spaces in depth; this page explains how kitchen and bathroom work affects the full property budget.
Electrical, Plumbing, HVAC and Smart Home Cost Drivers
MEP pricing begins with accessible condition and capacity, then follows the proposed equipment and routes. “Upgrade services” is not a measurable quotation line.
State what is tested, retained, extended or replaced and how final testing is recorded.
New positions can affect floors, walls, service access and external connections.
A ceiling design must leave equipment inspectable and serviceable.
Lighting or AC control is not the same scope as security and whole-home automation.
Roof, Façade, Windows and External-Scope Costs
External work can connect to the interior without belonging automatically to the same price. Put every interface and exclusion in writing.
| Decision | Question for the scope | Why it changes the budget |
|---|---|---|
| Roof and terraces | Is the work decorative, drainage-related or a waterproofing rebuild? | The affected assembly, access and test responsibility differ |
| Façade and windows | Are openings, external doors, glazing or visible elevations changing? | Weathering, structure and community appearance rules may apply |
| Landscape | Which paving, irrigation, lighting, drainage and planting zones are included? | Outdoor quantities and utility interfaces need their own schedule |
| Pool renovation | Is the work finishes, equipment, structure, decking or a new pool? | Each scenario uses different specialists, drawings and approvals |
Flooring, Stone, Joinery and Interior Finish Budget
Flooring needs measured areas, removal, background preparation, skirting, thresholds, stair edges, patterns and waste. Natural stone adds slab selection, fabrication, matching, sealing and maintenance decisions. Ceiling work requires heights, access panels, lighting and HVAC coordination. Painting depends on substrate repairs, the selected system and the junction where new work meets retained surfaces.
Joinery should be scheduled by unit rather than described as “wardrobes throughout”. Record dimensions, carcass and door materials, finish, internal fittings, hardware, lighting and installation access. The same discipline applies to doors, wall panels and media units. Named products and quantities make a villa renovation price in Dubai comparable; broad “standard” and “premium” labels do not.

Community NOC, Dubai Approvals, Access and VAT Budget Lines
Approval requirements depend on the address, jurisdiction and proposed changes. Dubai Municipality lists distinct services for building work; DDA has its own Building Modification Permit for completed projects in its jurisdiction. The DDA page currently states AED 1 per sq ft of relevant or additional built-up area, plus AED 10 Knowledge Dirham and AED 10 Innovation Dirham, with an estimated two-working-day delivery. That is one official service example, not a universal permit fee or programme.
Community NOCs, consultant work, authority submissions, deposits, access cards, protection, delivery windows, waste handling and utility changes should sit on separate budget lines. Dubai Electricity and Water Authority (DEWA) provides a distinct electricity network modification route through enrolled contractors or consultants where applicable. Dubai Municipality and DEWA are not interchangeable approval steps. The Federal Tax Authority states that the UAE standard VAT rate is 5%; every quotation should say whether VAT is included or excluded and separate refundable deposits from payable fees.
Occupancy matters as well. An occupied villa can require protected household routes, retained kitchen or bathroom facilities, temporary shutdown limits, extra cleaning and phased handovers. Ask the community or master developer for the current rules for the actual property rather than copying procedures from another villa in Dubai.
How to Build a Realistic Villa Renovation Budget
A useful budget grows from the same evidence later used for design, approvals and procurement.
- 01
Fix the area basis
Record built-up area and mark the exact internal and external zones that receive work.
- 02
Survey the baseline
Collect plans, photographs, maintenance history and accessible condition checks by system.
- 03
Choose the scope level
Separate retained, repaired and new work; do not call selected rooms a full renovation.
- 04
Schedule specifications
Name products, quantities, allowances, acceptable alternatives and the supply party.
- 05
Add outside lines
List design, approvals, deposits, access, storage, temporary needs and VAT separately.
- 06
Protect uncertainty
Keep provisional work and owner contingency visible, with a written variation process.
How to Compare Villa Renovation Quotations and BOQs
Issue one measured brief and compare each BOQ line by line. A renovation quote from a professional renovation company in Dubai should expose quantities, allowances and exclusions. This lets owners compare villa renovation companies in Dubai without treating different project boundaries as equal. The lowest headline can become the highest final cost when important work sits outside the total.
| Decision | Evidence to compare | What it prevents |
|---|---|---|
| Scope and quantities | Named zones, measured work, retained elements and exclusions | Different project boundaries appearing like equal offers |
| Products and allowances | Models, quantities, finishes, supply party and substitution rules | Undefined selections becoming later additions |
| Technical work | Structure, MEP, waterproofing, testing, commissioning and access | A finishes-only proposal looking like a complete scope |
| Third parties | Consultant work, applications, fees, deposits and utility work | Charges arriving outside the quoted construction sum |
| Commercial terms | VAT, milestones, provisional sums, variations and handover | Cash-flow and change-control differences being hidden |
What to Send for a Villa Renovation Cost Estimate
Send the location, built-up area, current drawings and recent photographs grouped by floor. Mark every room and external zone as included, retained or undecided. Add known leaks, cracks, service faults and earlier alterations; existing and proposed layouts; the number of kitchens and bathrooms; and any structural, façade, roof, landscape, pool, electrical, plumbing or HVAC change. This turns a broad villa renovation project into renovation work that can be measured.
Show the expected flooring, tile, sanitaryware, joinery, lighting, appliance and equipment level, then state who supplies each item. Include occupancy, access, community contacts and any approval documents already available. A target budget can guide options, but unknown items should remain visible. 800 Master Renovations can then identify the survey and specification inputs needed before preparing a property-specific written quotation.
- Plans, dimensions and current photographs by room
- Scope map with retained work and explicit exclusions
- Known defects, previous work and inspection records
- Finish references and contractor/client supply split
- Community, authority, utility, access and occupancy information
Villa Renovation Cost Dubai FAQ
01How much does it cost to renovate a villa in Dubai?+
FavoriteHome publishes AED 150–300 per sq ft for cosmetic work, AED 350–600 for mid-range work and AED 600–800+ for premium or luxury work. Property Finder publishes separate whole-project scenarios. These third-party figures are not company prices; an actual estimate requires a measured scope, condition review and written inclusions.
02How much does villa renovation cost per square foot in Dubai?+
The cited FavoriteHome guide uses AED 150–300, AED 350–600 and AED 600–800+ per sq ft for its three finish tiers. Before applying a rate, confirm the area basis and whether structure, MEP, kitchens, bathrooms, joinery, external work, approvals and VAT are inside the figure.
03What is included in a full villa renovation quotation?+
A full quotation should define protection, strip-out, structural and builder’s work, electrical, plumbing, HVAC, wet areas, flooring, ceilings, painting, joinery, products, testing, approvals, waste, snagging and handover. It must also state exclusions, client-supplied items, allowances, VAT and the treatment of concealed conditions.
04Why can two villas of similar size cost differently?+
Similar built-up areas can contain different bathroom counts, kitchens, staircases, plant, joinery and external zones. Existing structure and services, previous alterations, layout changes, access, occupancy and finish choices also vary. Compare the active work area and measured workstreams rather than applying one bedroom-count multiplier.
05How do kitchens and bathrooms affect a villa budget?+
They combine fitted products with plumbing, drainage, power, ventilation, waterproofing, tile or stone, joinery and equipment. Each room needs a schedule showing positions, quantities and supply responsibility. Moving wet services or selecting bespoke products can change more than the visible finish allowance.
06Can structural changes or an extension change the estimate?+
Yes. Openings, stairs and added area can introduce consultant design, temporary works, demolition, new structure, approvals and junctions with the roof, façade, drainage and MEP. The structural or extension scope should be priced separately from a retained-layout interior update.
07Do community approval, access and VAT affect the total?+
They can. Keep consultant services, submissions, authority fees, community deposits, protection, access, waste and utility work on separate lines. The UAE standard VAT rate is 5%, according to the Federal Tax Authority, so every proposal should state whether VAT is included or excluded.

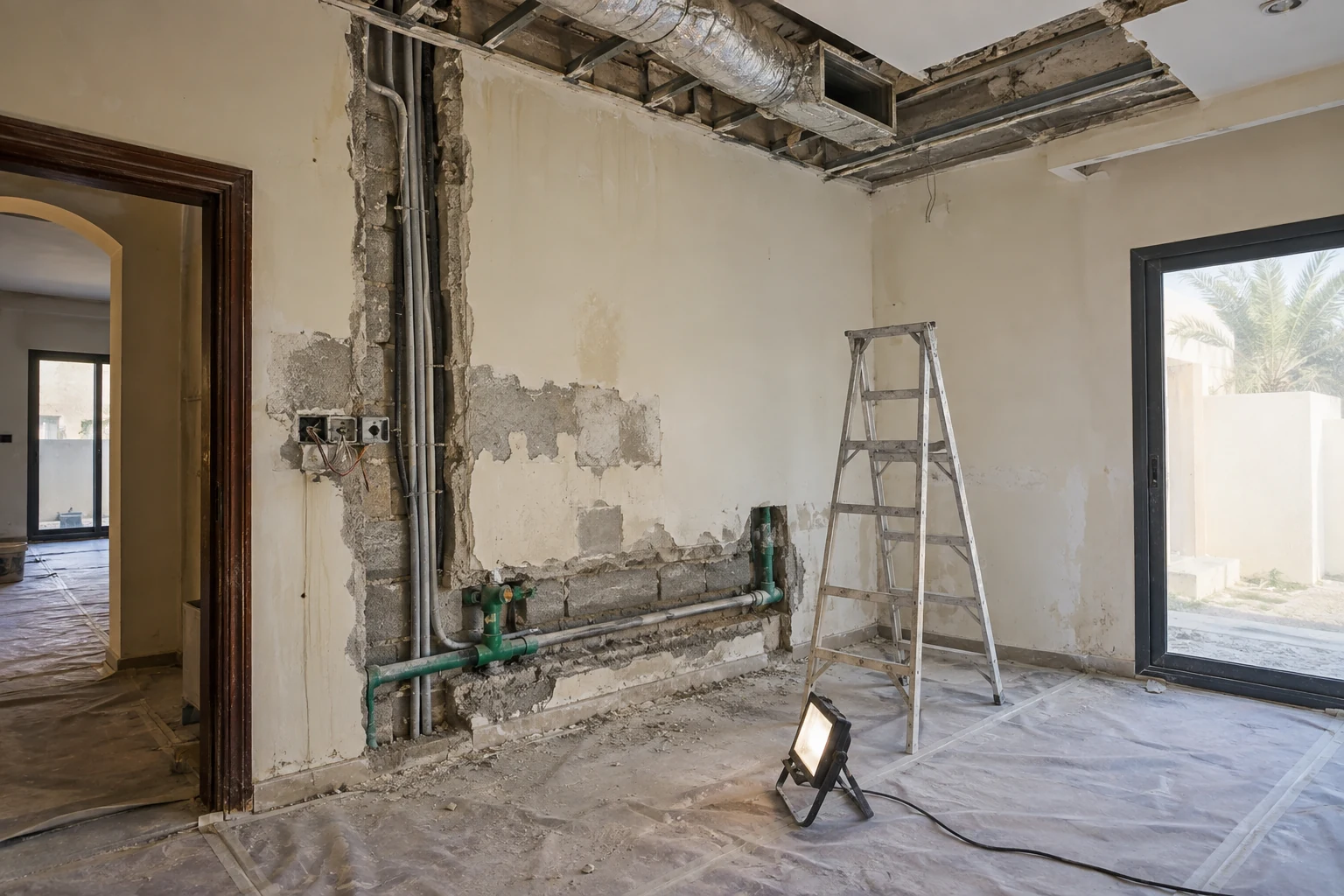

08What hidden costs may appear after strip-out?+
Opening-up may expose moisture damage, unsuitable substrates, undocumented structure, old wiring, corroded pipes or previous alterations. A proposal should identify reasonable assumptions and provisional items, then require photographs, valuation and written approval before additional work proceeds.
09Does 800 Master Renovations publish fixed villa packages?+
No. The AED figures on this page are attributed to external published guides and are not fixed 800 Master Renovations packages, prices or offers. A property-specific quotation follows review of the villa, measured scope, specifications, access, approvals, supply responsibilities and written exclusions.
